Project

General

Profile

Gantt

Filters

Zoom in Zoom out

months from Apply Clear

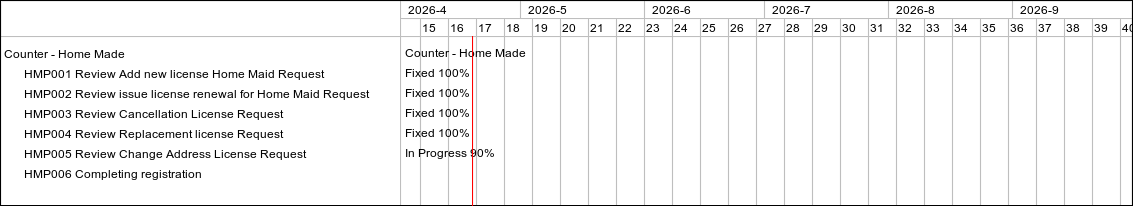

Task #2265: HMP001 Review Add new license Home Maid Request
Task #2266: HMP002 Review issue license renewal for Home Maid Request
Task #2267: HMP003 Review Cancellation License Request
Task #2268: HMP004 Review Replacement license Request
Task #2269: HMP005 Review Change Address License Request
Task #2327: HMP006 Completing registration

36
37
38
39
40
41
42
43
44
45
46
47
48
49
50
51
52
1
2
3
4
5
6
7
8
9
Counter - Home Made
Fixed 100%
Fixed 100%
Fixed 100%
Fixed 100%
In Progress 90%

« Previous Next »
